decentrahomes.com

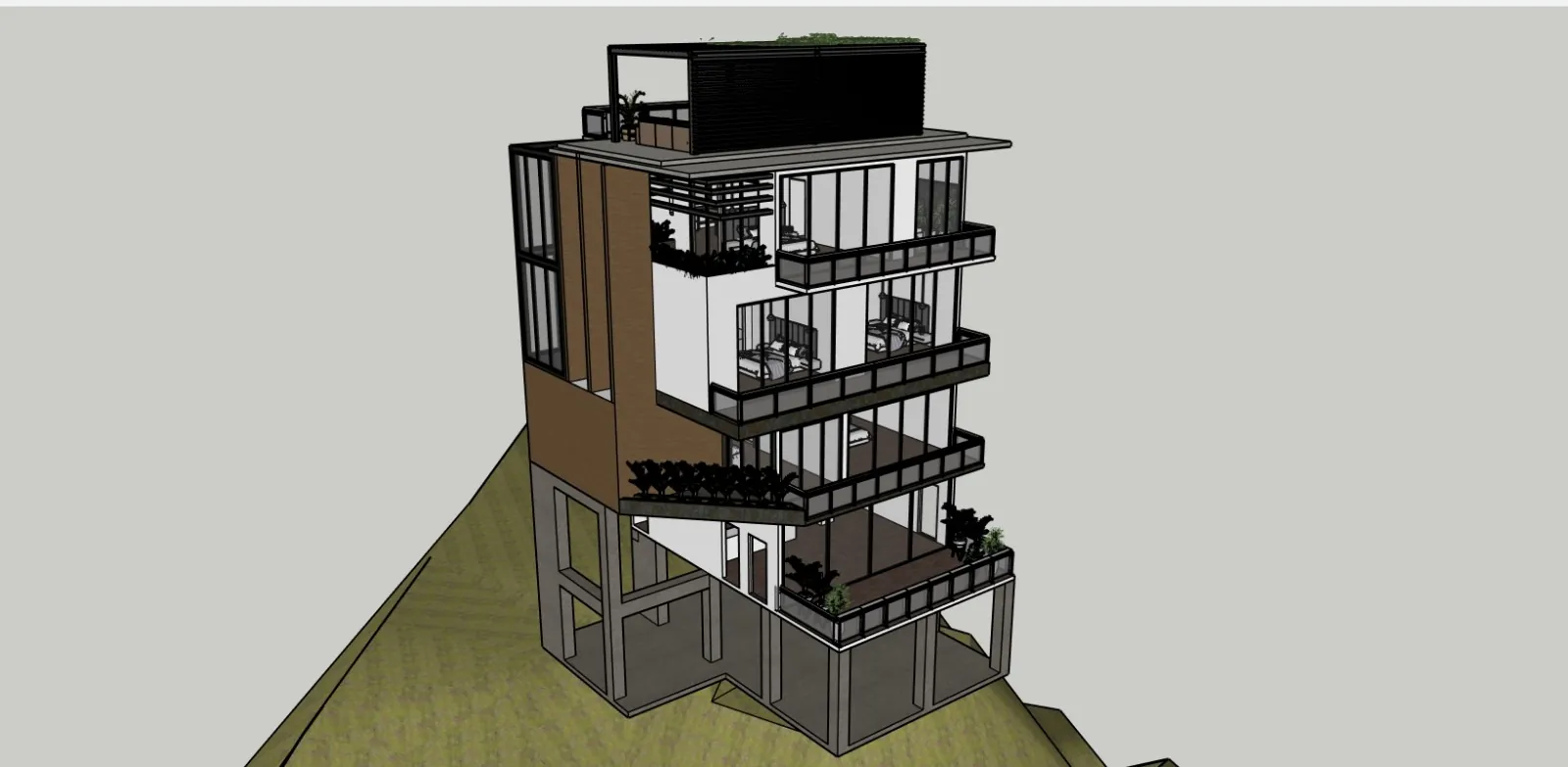

3D model of a multi-level hillside home prepared for permit drawings

Building permits and water letters in Costa Rica

Plans registered with the CFIA, the water letter in hand and the municipal permit issued, before the first shovel.

Minimum construction budget $350,000 USD, before land

In Costa Rica the permit is not paperwork at the end of design. It shapes the design from the start.

Every new home needs plans signed by a CFIA-licensed professional, registered through the CFIA’s online system and approved by the municipality. A missing water letter or a zoning detail can hold a project for months.

Because our architect designs and our team builds, we check each requirement while the drawings develop, then file the complete package.

Furnished floor plan of a custom Costa Rica home with open kitchen and living area
Floor plan prepared for the permit set
3D architectural model of a multi-level hillside home on a sloped Costa Rica lot
3D model checked against setbacks and heights

From plans to permit

  1. Land-use certificate

    The municipality confirms what can be built on the lot: use, height, coverage and setbacks.

  2. Water and electricity

    The water availability letter from AyA or the local water board, and the electricity availability from the provider.

  3. Plans and engineering

    Architectural, structural, electrical and plumbing plans to the seismic and electrical codes, signed by our CFIA-licensed team.

  4. CFIA registration

    Plans are submitted and registered through the CFIA’s online platform.

  5. Municipal permit

    The complete file goes to the municipality with title, survey plan, taxes and insurance, and the permit is issued.

Where permits get stuck

  • No water letter

    Coastal water boards have run out of capacity in several districts. We confirm the letter, or a storage and well plan, before design is final.

  • Protected areas and the coast

    The maritime zone, park buffers and river setbacks change what can be built. We check them on the lot.

  • Large or sloped projects

    Bigger projects can need environmental review and stormwater plans. We scope them before you commit.

What the municipality asks for

Requirements vary a little by municipality, but a typical new-home permit file includes the items on the right.

  • Plans signed and registered with the CFIA, electrical plan included
  • Land-use certificate (uso de suelo)
  • Water availability letter from AyA or the local ASADA
  • Registered survey plan (plano catastrado) and title report
  • Municipal taxes up to date and the INS workers’ policy
  • SETENA, road or river setbacks where they apply

Ways to get legal water for a building permit

Municipalities ask for proof of legal water before they issue a permit. There are several ways to get it, and they are not equally fast.

An AyA, ASADA or municipal availability letter is valid for one year. It can be extended before it expires, up to two times under AyA's 2015 regulation, so we time it with the design. A water capacity letter is a different document and is not accepted for a building permit.

  • AyA letter

    Where AyA, the national water utility, already runs an aqueduct.

  • ASADA letter

    Where a local water association registered with AyA runs the aqueduct. Some coastal ASADAs have no capacity for new connections.

  • Municipal aqueduct

    Less common, mainly in rural areas.

  • Drilled well concession

    A concession from the Environment Ministry's water department over a legally registered well, proving enough water of good quality. It has been taking about 12 to 18 months.

  • Spring or stream concession

    The same process over surface water, which is less reliable in the dry season.

  • Hand-dug well

    Listed as a legal source in INVU's 2021 regulations, but accepted only by some municipalities.

Extra approvals some lots need

Beyond the standard file, some lots need more. Requirements vary by municipality. This is from one municipality's 2026 list for major works.

  • National road frontage

    An alignment from MOPT when the lot faces a national route.

  • Rivers and streams

    A river alignment (alineamiento fluvial) from INVU when the lot borders a watercourse.

  • Stormwater

    A stormwater discharge approval for buildings over 500 m².

  • Environmental viability

    SETENA viability for buildings over 1,000 m², and wherever the site calls for it.

  • Shared ownership

    Written consent from every owner when the property has more than one.

Building permits by town

Every permit goes through the CFIA and the local municipality, but zoning, coastal plans and water differ from town to town. This is what applies where we build.

TownMunicipalityZoning or coastal planWater
AtenasMunicipalidad de AtenasNo cantonal plan regulador (INVU data, May 2026)AyA in most of the central district; ASADAs in other districts
Avellanas and Playa NegraMunicipalidad de Santa Cruz, GuanacasteNo municipal plan yet; Santa Cruz targets Q1 2027ASADA and public systems plus private wells; varies by lot
Ciudad ColónMunicipalidad de MoraMora plan regulador of 1993, amended in 2001 and 2008AyA
DominicalMunicipalidad de Osa; lots north of the Barú River fall under QueposNo cantonal plan regulador in OsaASADA or AyA letter; Fila Costeña springs
EscazúMunicipalidad de EscazúUso de suelo certificate confirming the plan regulador zoneAyA, Oeste-Sur group of subsystems
GreciaMunicipalidad de GreciaUso de suelo certificate under Grecia’s plan reguladorMunicipality of Grecia and local ASADAs
HuacasMunicipalidad de Santa Cruz, Tempate districtNo municipal plan yet; coastal and urban plan targeted for Q1 2027Huacas-Tamarindo aquifer; new wells banned since 2016
Jacó and HerraduraMunicipalidad de Garabito, Puntarenas provinceCurrent zoning for the lot while the new regulatory plan is debatedAyA system, under an upgrade program now due to finish in June 2029
JunquillalMunicipalidad de Santa Cruz, Veintisiete de Abril district, GuanacasteAvellanas-Junquillal coastal plan, in La Gaceta since September 2017Confirmed lot by lot before purchase
La FortunaMunicipalidad de San Carlos (Ciudad Quesada)None, La Fortuna is inlandLocal ASADAs; AyA revoked Sonafluca’s delegation in 2026
Lake ArenalMunicipalidad de Tilarán, Guanacaste provinceNone, the lake is inland; a lakeshore protection zone applies insteadConfirmed lot by lot before purchase
Las CatalinasMunicipalidad de Santa CruzArchitectural Review Board under the town's guidelinesPotrero-area ASADA wells; confirm the letter first
LiberiaMunicipalidad de LiberiaCurrent zoning for the lot, given the canton plan still in processAyA supply; plan storage for dry-season interruptions
LimónMunicipalidad de LimónStructural design to the CFIA seismic codeAyA, from the Río Bananito intake
Manuel AntonioMunicipalidad de Quepos (canton renamed from Aguirre in 2015)Current water availability letter from AyA or the local ASADAAyA Quepos-Manuel Antonio aqueduct; ASADAs in outlying communities
MontezumaConcejo Municipal de Distrito de Cóbano, Puntarenas canton and provinceCabuya-Montezuma coastal plan, in La Gaceta since September 2016Asada de Montezuma supplies the village
NosaraMunicipalidad de Nicoya, Nosara districtNo regulatory plan; Ostional buffer rules applyASADA letters; new permits interrupted repeatedly since 2020
OjochalMunicipalidad de OsaNo cantonal plan regulador in OsaFila Costeña springs; we confirm the supplier for each lot
Osa PeninsulaMunicipalidad de Puerto Jiménez, Puntarenas province (in office since May 2024)200 m zone (ZMT) along the gulf and Pacific coastsConfirmed lot by lot before purchase
PapagayoMunicipalidad de Liberia; land within the ICT Papagayo tourism poleICT concession model; tenure confirmed per homesite by an attorney2019 audit: 12 of 35 concessions lacked water; Playa Panamá drilling restricted
PavonesMunicipalidad de Golfito, Puntarenas provinceGolfito coastal plan, Sector Costero BConfirmed lot by lot before purchase
Playa FlamingoMunicipalidad de Santa Cruz, Cabo Velas districtNo municipal plan yet; coastal and urban plan targeted for Q1 2027Stressed coastal aquifers; new wells banned in Brasilito-Potrero aquifer since 2016
Playa GrandeMunicipalidad de Santa Cruz, Cabo Velas districtNo Santa Cruz plan regulador in force yetCabo Velas ASADAs listed in 2024 as lacking capacity for new permits
Playa HermosaMunicipalidad de Carrillo, Sardinal district, GuanacasteWater availability letter from AyA or the ASADA that serves the lotAyA network, reinforced by the Las Trancas aqueduct (an extra 120 L/s for the area)
Playas del CocoMunicipalidad de Carrillo, Sardinal districtWater availability letter before purchaseAyA aqueduct, second stage delivered March 2019; new wells restricted
Potrero and BrasilitoMunicipalidad de Santa Cruz, GuanacasteNo municipal plan yet; Santa Cruz targets Q1 2027AyA and local ASADAs; availability confirmed lot by lot
Puerto ViejoMunicipalidad de Talamanca, Limón provinceWater availability confirmed in writing, or a legal water source on the lotAyA Hone Creek to Puerto Viejo system, in deficit in 2021 figures
San JoséMunicipalidad de San JoséReglamentos de Desarrollo Urbano; mixed-use zone rules being rewrittenAyA; 71% of the 31 metro subsystems face seasonal deficits
San RamónMunicipalidad de San RamónNo plan regulador in force (INVU data, May 2026)AyA; new San Ramón aqueduct reported finished in June 2026
Santa AnaMunicipalidad de Santa AnaNew plan regulador in force since October 5, 2026AyA, Oeste-Sur group of subsystems
Santa TeresaConcejo Municipal de Distrito de Cóbano (Puntarenas)Cóbano coastal plans; 25% coverage in low-density residential zoneConfirmed lot by lot before purchase
SámaraMunicipalidad de Nicoya, Sámara districtWater letter from the ASADA before purchaseASADA supply; no feasibility for new permits in 2024
TamarindoMunicipalidad de Santa Cruz, Tamarindo districtNo municipal plan yet; coastal and urban plan targeted for Q1 2027Huacas-Tamarindo aquifer, officially over-exploited; new wells banned in 2016
UvitaMunicipalidad de Osa (seat in Ciudad Cortés)No cantonal plan regulador in OsaASADA letters; supply from Fila Costeña springs

Each town page has the full permit checklist and sources. Before you buy, we confirm the land-use certificate, the water letter, the topographic survey and the soil study for the specific lot.
